Portfolio: Cost Summary Column Definitions

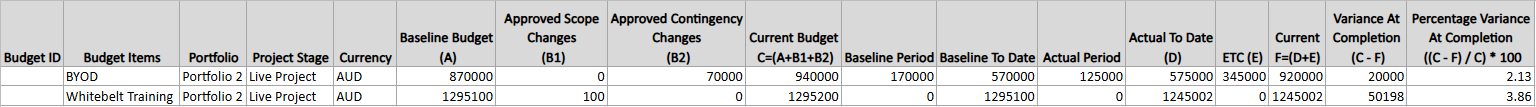

Click the table for a closer view:



Budget IDThe unique ID assigned to a Portfolio level cost. IDs cannot be duplicated within the same portfolio. This ensures all costs are logged and tracked systematically.
Budget ItemsList of all projects and portfolio costs associated with the portfolio.
PortfolioPortfolio name which individual projects or subportfolios are assigned to.
Project StageIdentifies current stage/phase of the projects within the portfolio. Not applicable (NA) will display if the item relates to a portfolio only.
CurrencyThe currency that the Portfolio or Project Financials will be based on
Baseline Budget (A)The initial, approved and allocated estimate of a project's costs, used as a benchmark to track and compare actual spending.
Approved Scope Changes (B1)Any approved change requests to the original baseline budget; an adjustment to the project's budget that is formally agreed upon to accommodate changes in the project's scope, or cost constraints.
Approved Contigency Changes (B2)Any approved change requests to cover unforeseen costs, allowing for necessary changes in a project without derailing the entire budget.
Current Budget C=(A+B1+B2)The current revised budget comprised of the original baseline budget plus approved changes to the budget.
Baseline PeriodBaseline costs as per the reporting period.
Baseline To DateBaseline costs from project start up to the reporting period.
Actual PeriodActual expenditure for the reporting period.
Actual To Date (D)Actual expenditure from project start up to the reporting period.
ETC (E)The total predicted cost  to complete the remaining work, from the current point until the project's conclusion. This includes the forecast costs of current and future periods.
Forecast Final Cost - Current F=(D+E)Total forecast expenditure based on total actual expenditure to date plus estimated expenditure (forecast) to complete remaining work.
Variance At Completion (C - F)The projected cost difference at completion between the current budget and the current forecast final cost. Identifies variances that may require corrective measures to be implemented.
Percentage Variance At Completion
((C - F) / C) * 100
This calculates the forecasted over or under-run of a project's total budget, expressed as a percentage.
