1. Overall Project Progress - Calculations
The Overall Project Calculations is based on the start and finish date of the Schedule, not the project dates, although generally it would be expected the dates of the schedule would align to the project dates.
There are there are two ways the Overall Project Progress is calculated:
1. Effort Based
Project schedules that have at least one task that has an effort value should show an overall progress bar that shows that current percent complete of the total schedule based off the total actual effort percentage complete.
ie. (actual effort / effort * 100) rounded to the nearest integer

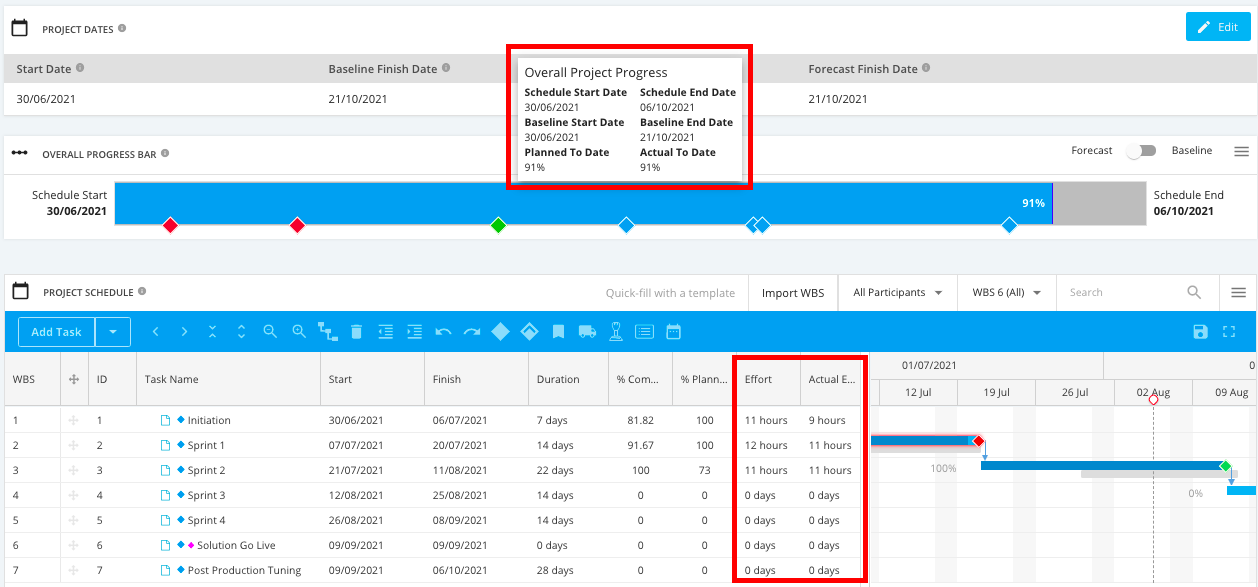

Example:
Schedule Progress Calculation – Today’s date 05/08/2021 | |||||||||||||||||
Formula: | Calculations: | ||||||||||||||||
Step 1 – Planned to Date % Task (Current Date – Start Date + 1)100 Task (Duration) + 1 Duration = total number of calendar days between schedule start and finish dates Overall Planned % To Date= Sum of all Planned % Tasks with Effort Values Number of Tasks with Effort Values | WBS 3 (11/08/2021 – 21/07/2021) + 1
(16/22) x 100 = 72.72% = 73%
Overall (100+100+73) 3 = 91% | ||||||||||||||||
Step 2 – Actual to Date % (Actual Effort/ Effort) x 100
Overall Actual % To Date= Sum of All Actual Effort x 100 Sum of All Effort |
Overall 31 34 = 0.9117647059 = 91% |
2. Duration Based

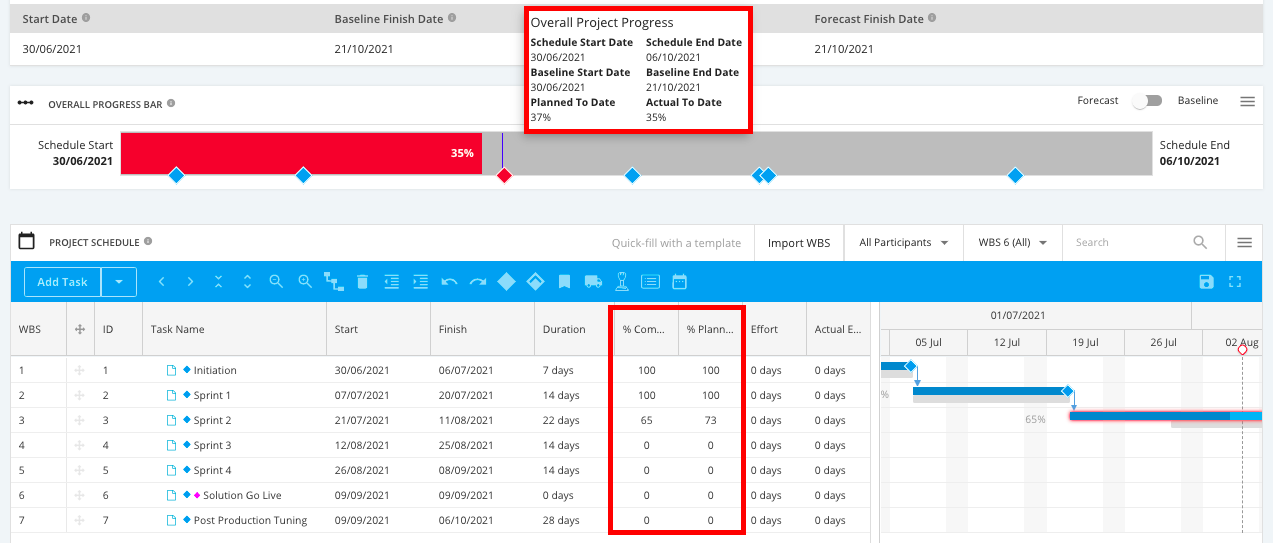

Project schedules that have no tasks that have an effort value should show an overall progress bar that shows the current percentage complete based of the percentage complete column values.
ie. (Sum(% complete * duration) / total duration) * 100)
Example:
Schedule Progress Calculation – Today’s date 05/08/2021 | |||||||||||||||||||||||||||||||||||||
Formula: | Calculations: | ||||||||||||||||||||||||||||||||||||
Step 1 – Planned to Date % Task (Current Date - Start Date +1) Task (Duration) + 1 Duration = total number of calendar days between schedule start and finish dates
Overall Planned % To Date= Total of Task (Current Date - Start Date +1) Total of Task (Duration) + 1 | WBS 3
= 16
= 23
For Future Tasks, Duration is set to 0 as it would be impossible to subtract a Future Date from the Current Date. Given this, the + 1 Calculation is also ignored. Overall 39 106 = 0.3679245283 = 37% | ||||||||||||||||||||||||||||||||||||
Step 2 – Actual to Date % Total (%Complete x Duration) Total (Duration)
Planned Effort = Duration of calendar days per WBS |
Overall 35.3 100 = 0.353 = 35% |
